Roofing

What EuroShield Roofing Actually Costs for Small and Large Projects

EuroShield roofing cost

EuroShield is 1 company, not a type of roof. It is made in Calgary, Alberta, out of ground up tires, somewhere between 250 and 1,000 of them go into a house roof depending on the size, and the shingle that comes out of it is sold in 2 looks, a shake and a slate. The price sits above asphalt and below the natural slate and cedar it is copying, and the table below is what that comes to on 3 roof sizes, installed, before the extras.

RoofLow endHigh end
1,500 sq ft, 15 squares$12,750$21,750
2,500 sq ft, 25 squares$21,250$36,250
3,500 sq ft, 35 squares$29,750$50,750

Tear off, deck repair and flashing sit on top of those figures and are on the first image further down. Hmm, and the odd thing you will see in the sections after this is that the small roof can cost more per square foot than the big one, which is the thing to hold onto before the quotes start coming in.

What EuroShield Costs Per Square Foot Now

Installed, with the labor in, EuroShield has been running $8.50 to $14.50 a square foot across the US and Canada, which is the range roofingcalc has carried since 2021 and the one the quotes we have seen still land inside. Roofers price in squares, 1 square being 100 square feet, so that is $850 to $1,450 a square, and the spread between the 2 ends is the profile, the pitch and where you live.

The current profiles, with their weight per square from EuroShield’s own spec sheet:

  • Beaumont Shake, 240 lb a square, and Beaumont Shake HP at 265 lb.
  • Ranchlands Shake, 310 lb.
  • Vermont Slate, 240 lb, and Vermont Slate HP at 265 lb.
  • Rundle Slate, the heavy one at 360 lb.

Asphalt is around 200 to 250 lb a square, so the lighter EuroShield profiles weigh about what the roof is already carrying and the Rundle Slate is half as much again, which still needs no extra framing on an ordinary truss roof. Natural slate would be 800 lb and up, and that is the comparison the weight is there for.

How The Cost Changes On A Bigger Roof

A bigger roof takes more shingles, more underlayment and more flashing, and in the other direction it spreads the fixed part of the job thinner. The crew, the dumpster, the scaffold and the permit cost about the same whether the roof is 12 squares or 30, so if you take all of that as a flat $2,000 or so, over 10 squares it is $200 a square and over 30 squares it is under $70. That is the reason the per square price drifts down as the roof grows.

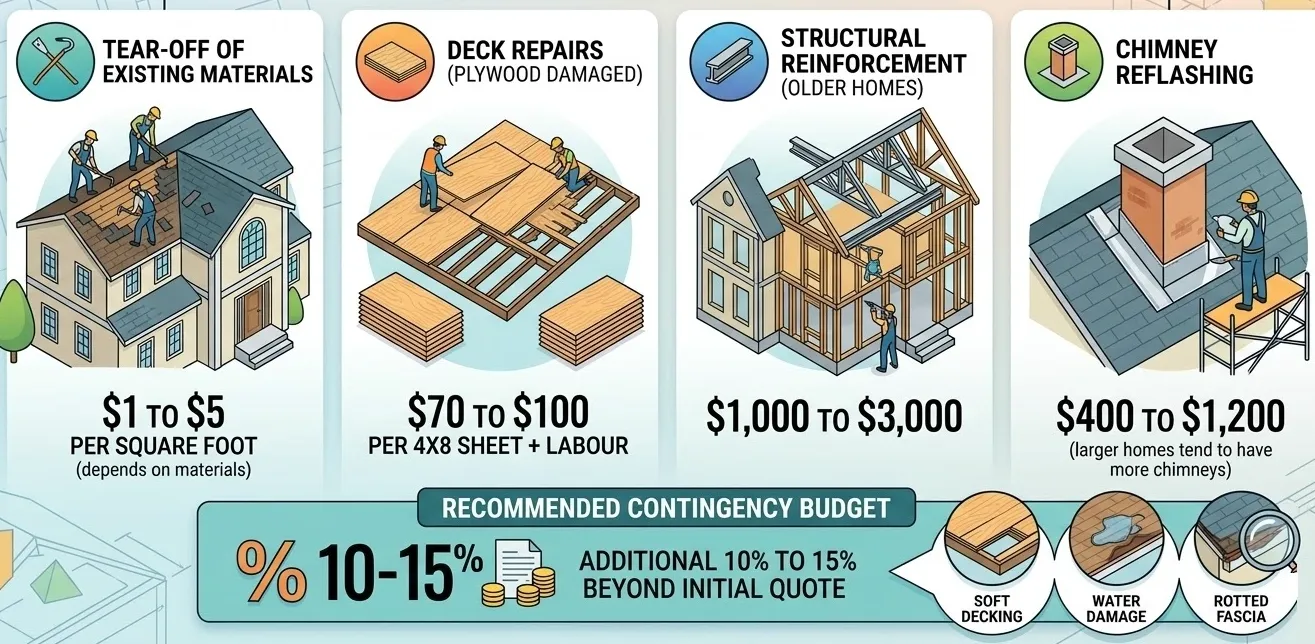

It drifts back up with complexity, and big houses have more of it, more valleys, more dormers, more chimneys, more pipes through the deck. EuroShield already takes 30 to 50% more labor hours than asphalt on the same roof because the panels are heavier and each one has to be seated in a lock, so every dormer on a big house is a dearer dormer than it would have been in asphalt. The extras to watch for on a large job, which are the 4 on the image below:

  • Tear off of the old roof, $1 to $5 a square foot depending on how many layers are up there.
  • Deck repair where the plywood has gone soft, $70 to $100 a 4×8 sheet plus the labor to fit it.
  • Structural work on an older house, $1,000 to $3,000.
  • Chimney reflashing, $400 to $1,200 each, and a big house may have 2 or 3.

Most contractors will tell you to keep 10 to 15% over the quote for what turns up once the old roof is off, soft decking, water damage, rotted fascia, because none of it can be seen until the tear off day.

Why Larger Roofs Don't Just Cost More

Why A Small Roof Costs More Per Square Foot

A 1,000 square foot bungalow will never reach the bill of a 3,000 square foot colonial, and it can still cost more for each square foot of it. The contractor has to turn up with a crew, haul the material, set the safety gear and pull the permit for 10 squares the same as for 30, and that $2,000 from the last section divided by 10 is where the higher unit price comes from.

What helps a small roof is a simple one. A single slope, 1 vent pipe, no skylight, no chimney, is a day or 2 of work, and with this product the work has a rhythm to it that a crew either knows or does not.

Each shingle gets 6 nails and the panel tells you where to put them, the first row runs off a starter strip at random, and every row after that hooks into a groove on the row below and slides down into the lock, with tabs on the panel to keep the lines straight. A crew that has done it 50 times moves down a slope like that at speed. A crew doing its first one stops at every lock, and you are paying for every stop.

The profile matters more on a small roof than a big one, because the difference between the shake and the slate prices is a bigger share of a small bill. Between the 2, we would pay for the slate. The shake reads as rubber from the sidewalk and the Vermont Slate does not, and it is a roof you are going to look at for 50 years.

What Pushes The Price Up At Any Size

Pitch first. A roof between 4 in 12 and 6 in 12 is ordinary ground for a crew, and once it goes past 7 in 12 the price goes up, because everything on a steep roof is slower, the harnesses go on, the material comes up in smaller loads, and the men walk differently. A 2,000 square foot roof that is 1 level with clean lines can come in under a 1,500 square foot roof with 3 dormers, a steep pitch and 2 skylights, and the quote will say so if you ask for the labor line on its own.

Euroshield roofing pricing moves with the address as well, a crew in rural Missouri bills less an hour than one on the California coast, and since the panels are made in Calgary the freight to the distributor is in the price and it is not the same in Texas as it is in Montana. And then the profile, the slate costing more than the shake because it is doing a harder job of looking like stone.

The 50 Year Arithmetic

EuroShield runs somewhere between half as much again and twice the price of asphalt installed, depending on whose quote you are reading, and that is the number that stops people. Asphalt gives you 15 to 20 years on a good day, EuroShield’s warranty runs 50, and the HP profiles carry a guarantee against hail of any size for the first 20 years. So the sum over 50 years is 3 asphalt roofs, each with its own tear off, against 1 of these, and that sum comes out the other way from the quote.

If you have recently had hail damage you probably have a lot of door knockers offering you roofs, and a lot of them will try to sell you class 4 asphalt shingles. There are 2 types of shingle for a hail area, the ones that can take the hail, which is rubber, some metal and a few other products, and the ones that take it on paper.

In 2026 you have a lot of asphalt makers selling class 4 impact rated shingles, and some of them claim hail warranties on top, and if you read those warranties closely you will see they protect the company from expensive lawsuits and not your roof. Roofers who work hail country have seen asphalt go at 2 inch hail and have not seen the rubber go at 3. You cannot fight with common sense.

Every EuroShield profile is UL 2218 Class 4 listed, the top impact rating, and many insurers in hail states will take a few percent off the premium for it, so ask yours before the quote, because the discount is part of the arithmetic.

Two costs the sales pages leave out. The rubber smells for the first weeks, strongest in hot weather, and some owners have kept the windows shut until it faded. And the warranty wants a certified installer, which in some areas means a wait of weeks for the crew and a travel fee on the quote, and it wants the attic ventilated properly, because heat shrinkage from a hot attic is excluded.

Against that, the maintenance is soap and water and a look after a storm, and the thing does not crack in cold, warp or rot. Against the other 2 it gets compared with, standing seam metal has been quoting $8 to $30 a square foot and cedar shake $14 to $30 with a cleaning and treatment bill every few years on top, so EuroShield sits at the bottom of that company on price and the cedar is the only one that costs more to own.

Getting The Quote Right

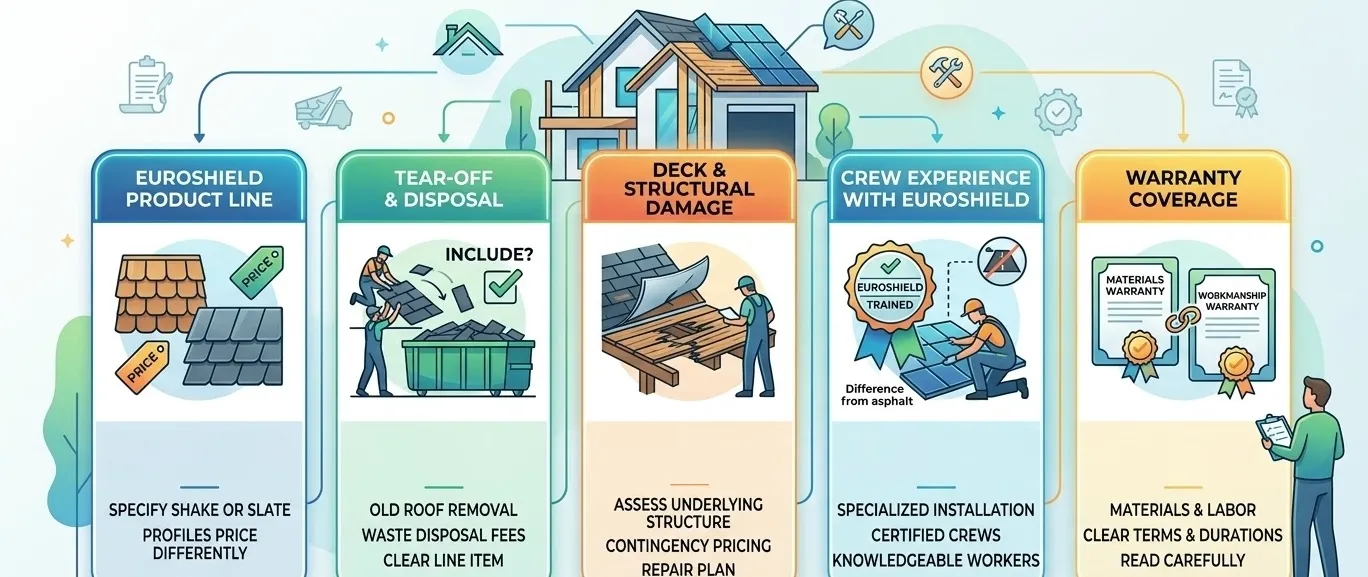

Three quotes at least, whether it is a garage or the full house roof, and each one has to break out the materials, the labor, the tear off, the disposal and the extras as separate lines, because a single number cannot be compared with another single number. The questions, which are the 5 on the second image:

  • Which profile is being quoted, since shake and slate price differently.
  • Whether the tear off and the disposal are in the number.
  • What happens on price if the deck turns out soft on tear off day.
  • How many EuroShield roofs this crew has done, because the lock system is a different day’s work from asphalt and a first timer is slower and wastes more.
  • The warranty on the material and the separate one on the workmanship, in writing, with the years on each.

A crew trained on asphalt can be trained on this, which is an advantage over metal roofing with its own tools and its own trade, but trained and experienced are different words on a quote. Choose wisely, choose with a heart and common sense, not what the sales rep tells you.
